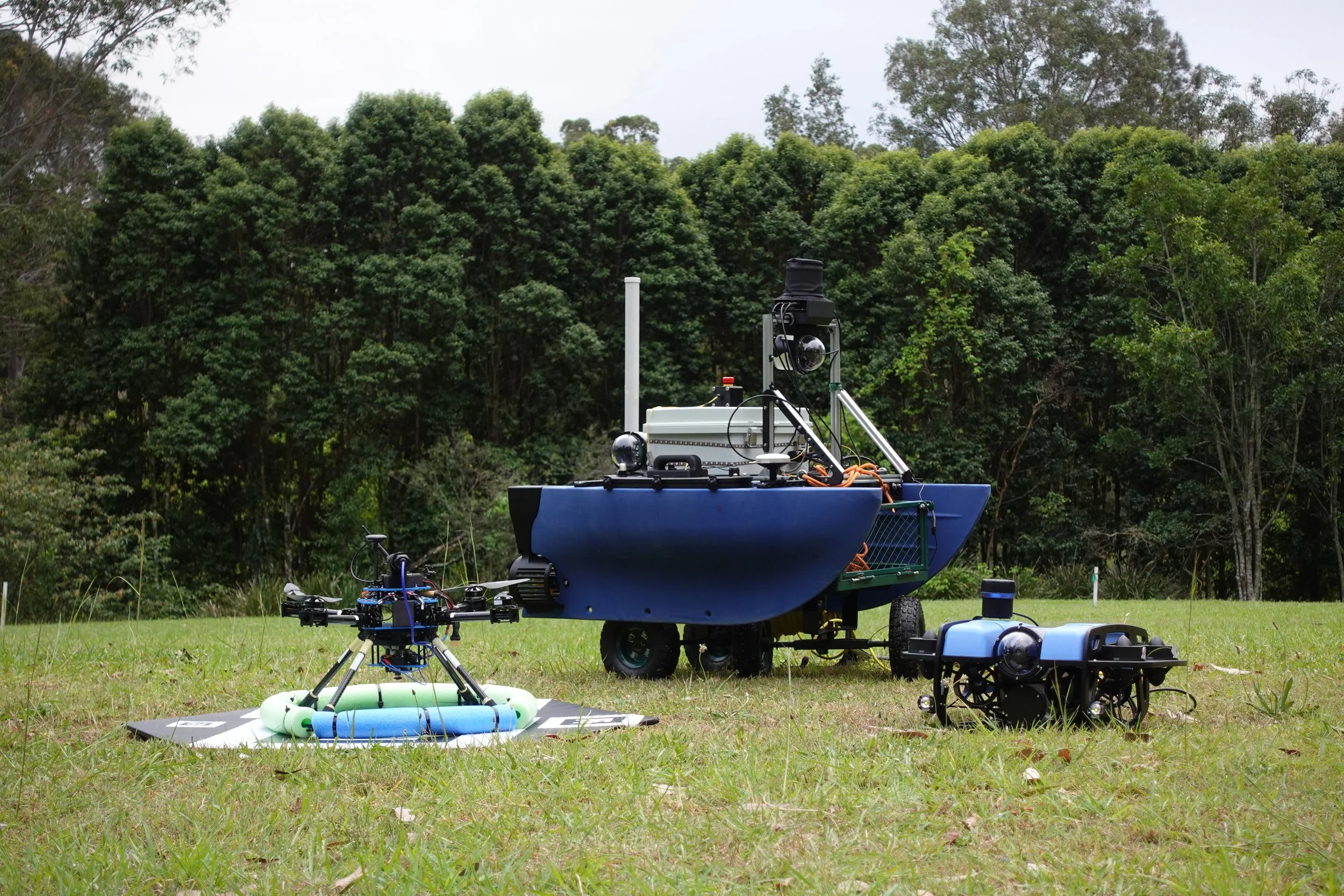

NU Marine Testing Timeline

Some of the major milestones in the development of our platforms

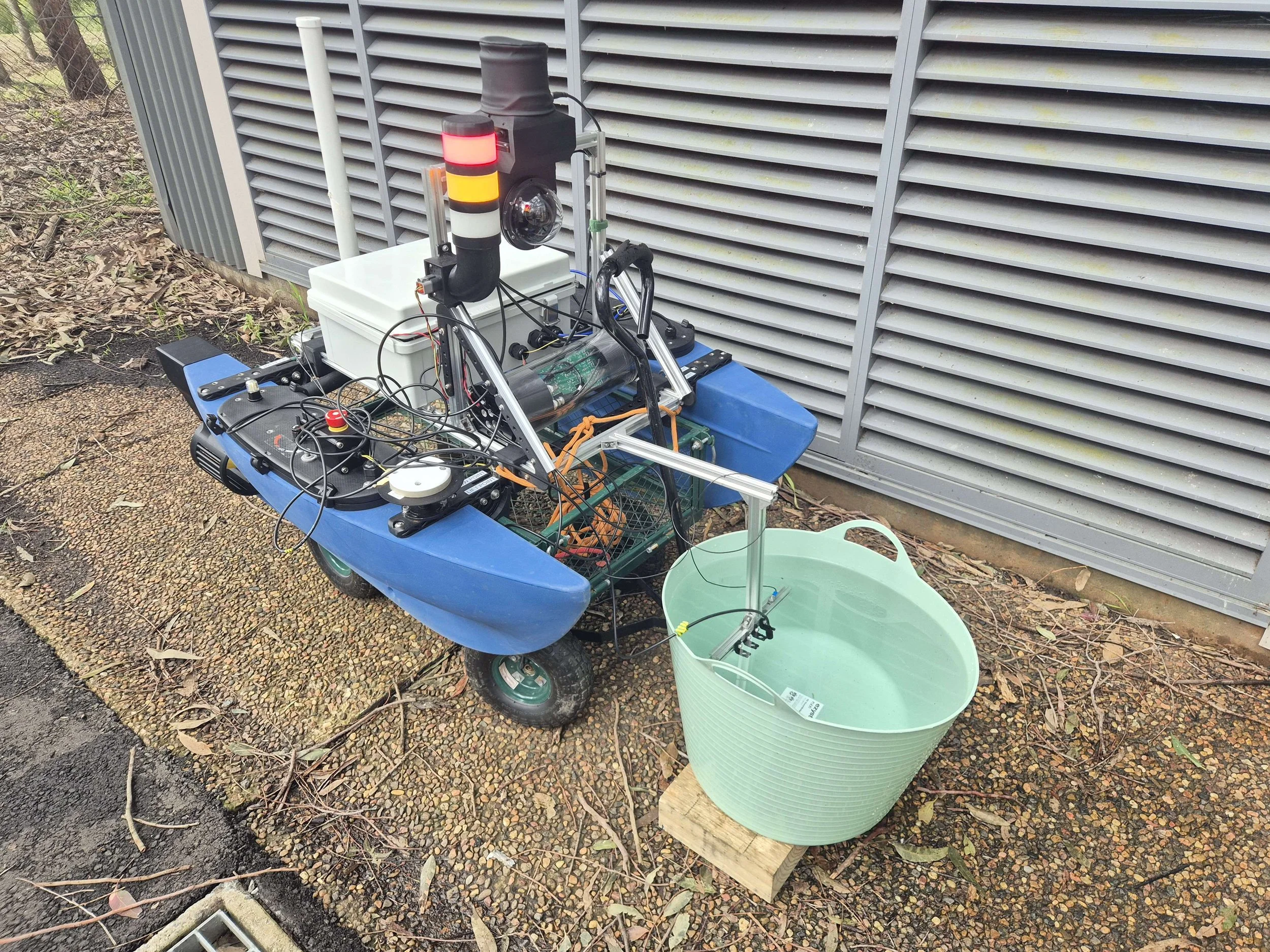

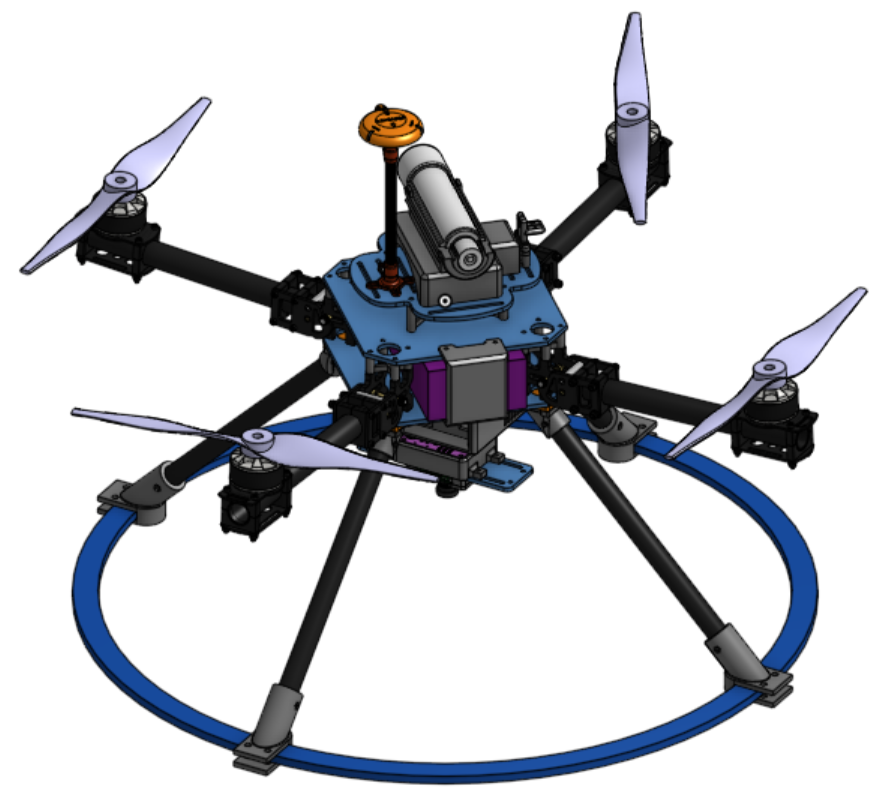

USV - Atlas

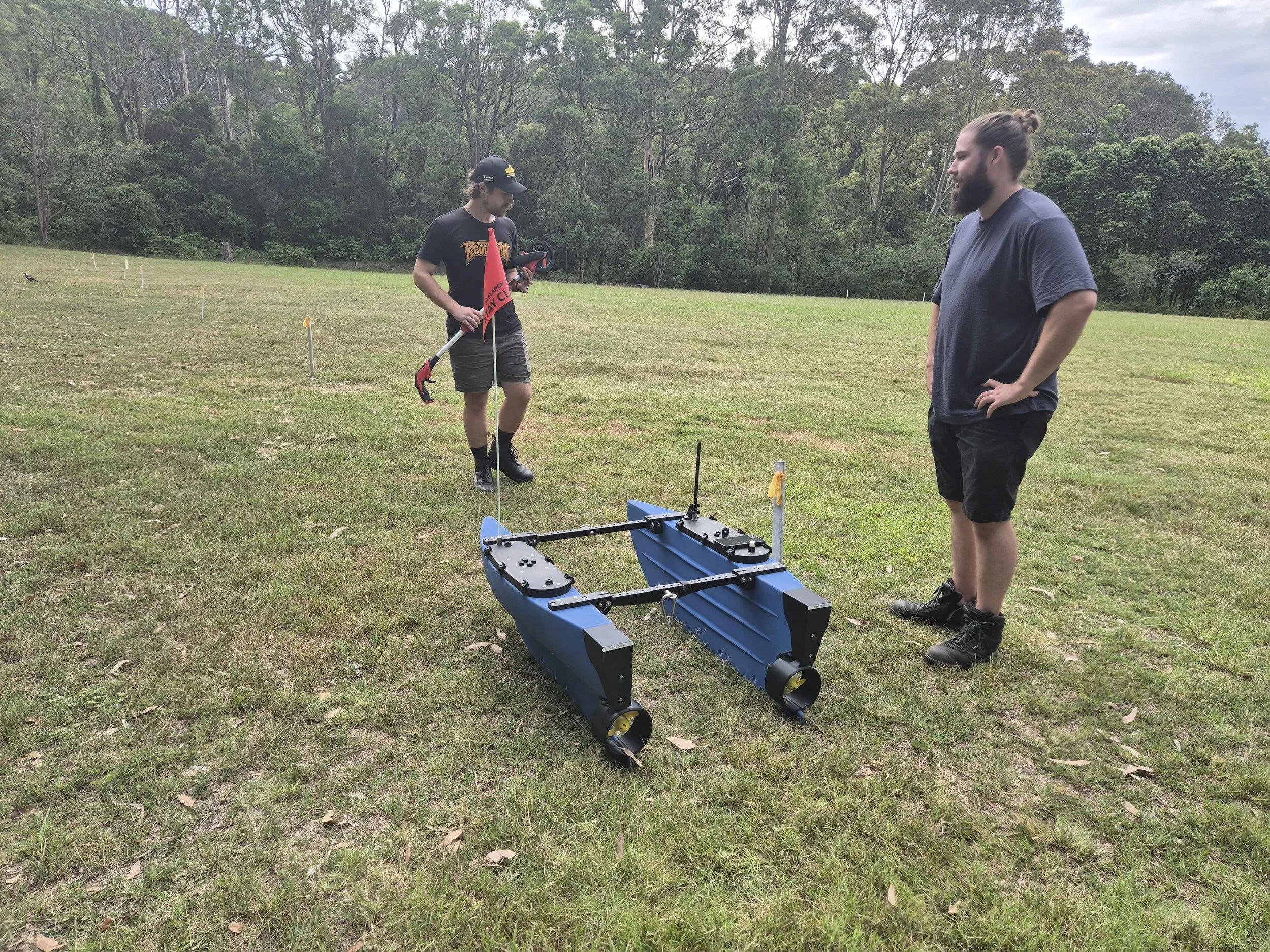

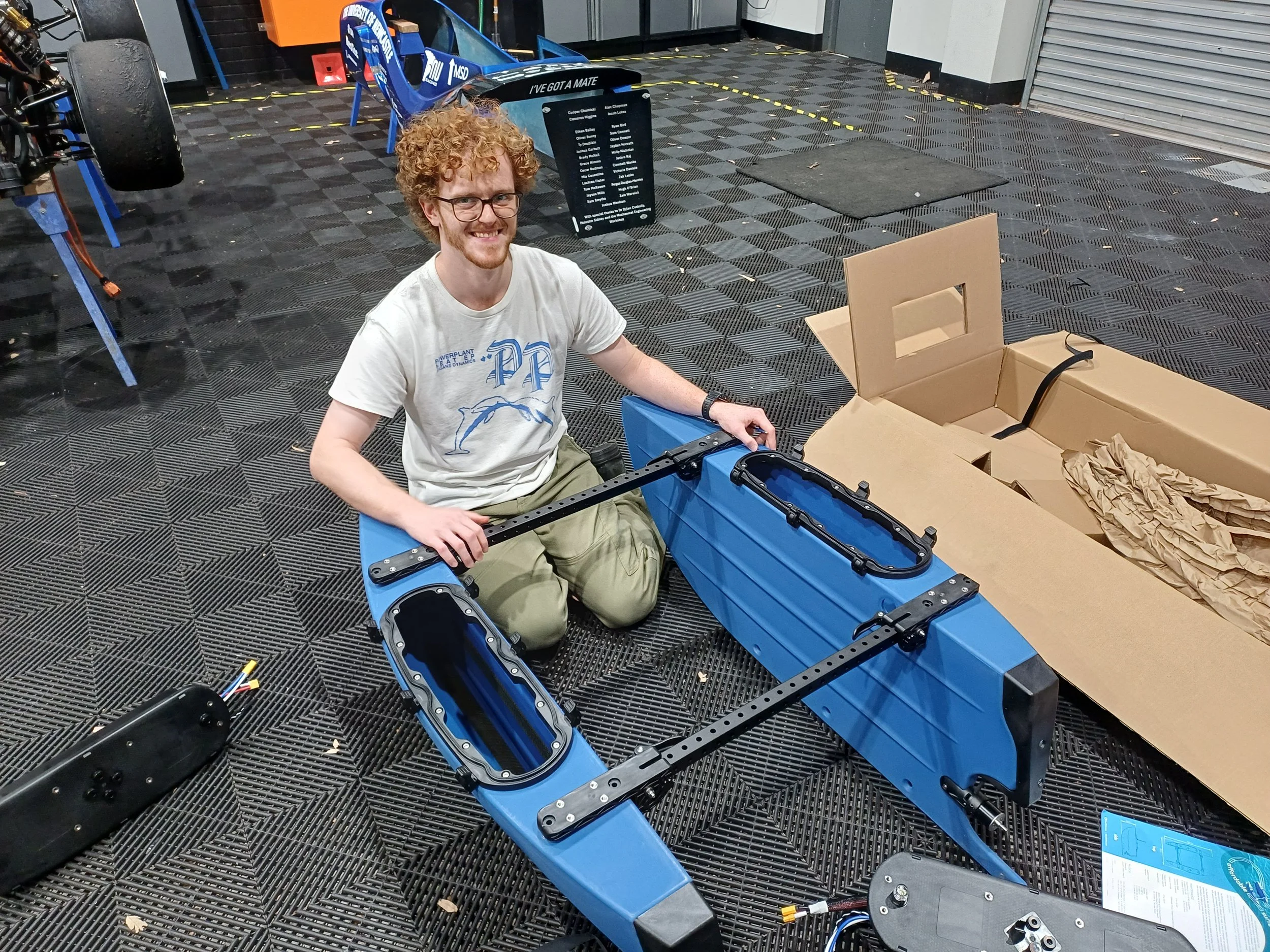

14th - 30th Jan 2026

  • Assembly of Atlas, our USV

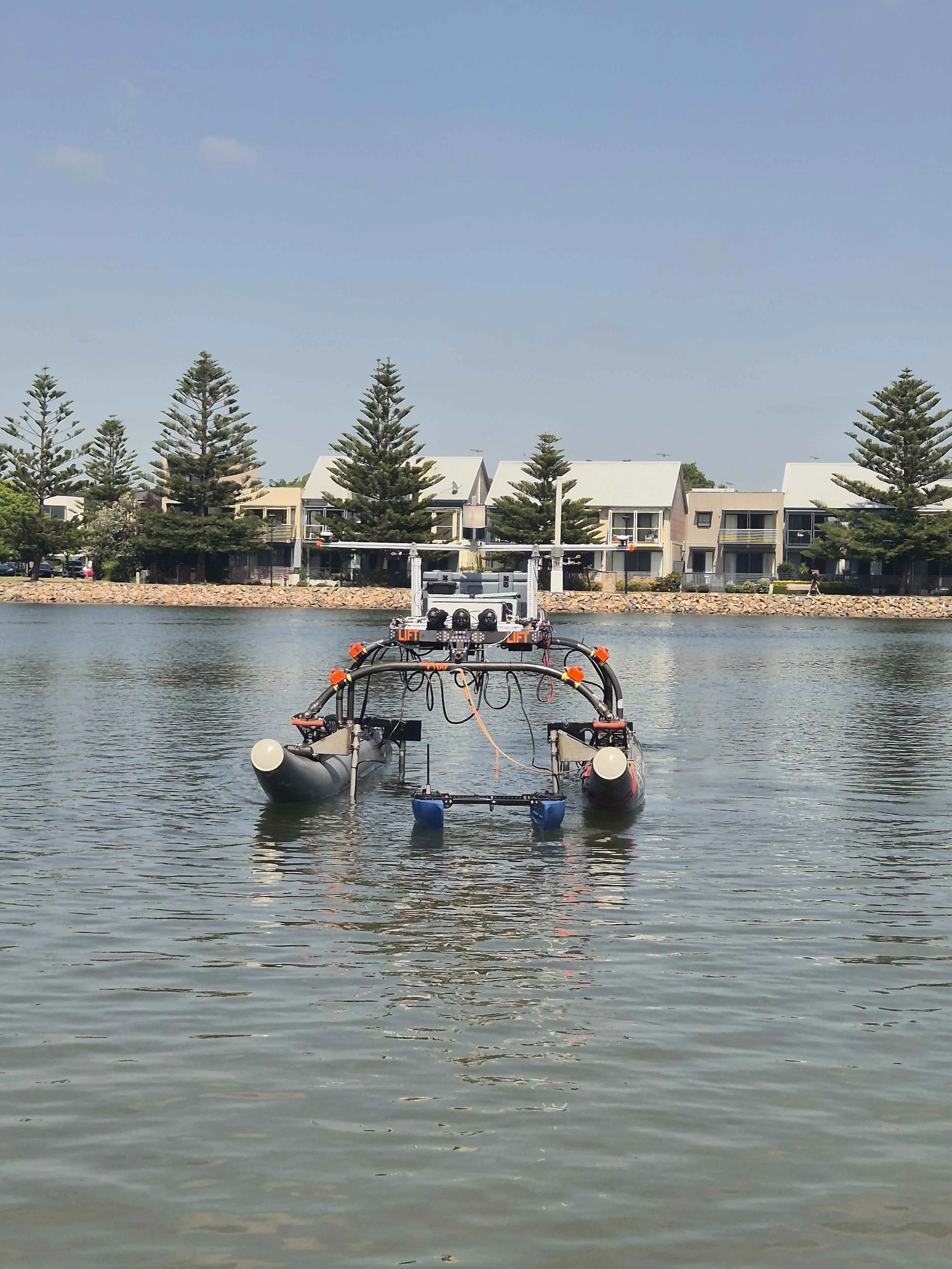

6th Feb 2026

  • First on the water test day with our old WAM-V and new BlueBoat platforms

19th Feb 2026

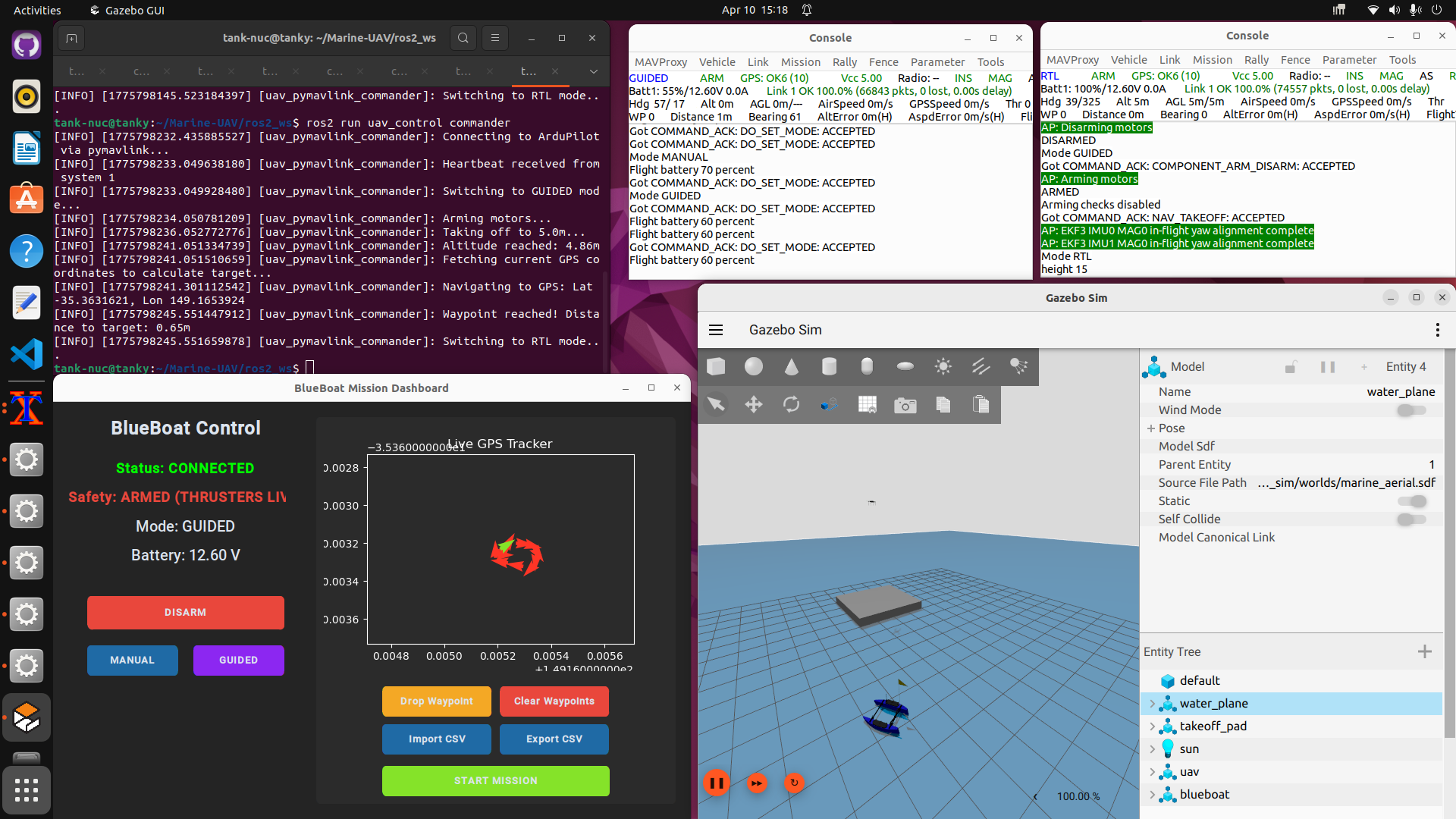

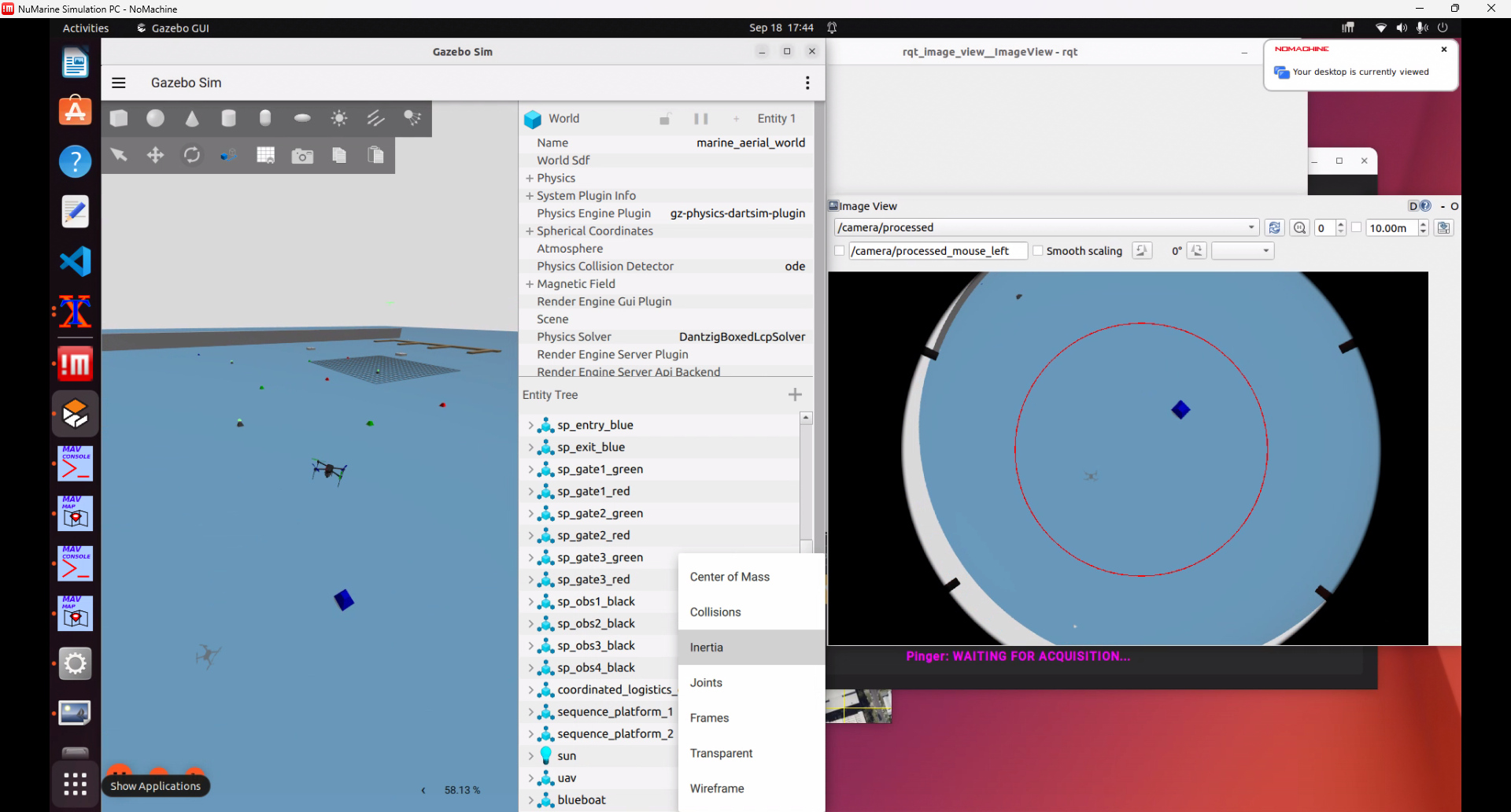

  • Integration of ardupilot and ROS software within the gazebo simulation of our USV, Atlas

24th Feb 2026

  • GPS data collected from Atlas using ROS and pymavlink

27th Feb 2026

  • On the water test day with Atlas. Verified failure states. Conducted some initial PID tuning. Manually placed waypoints using Qground control and ROS

4th Mar 2026

  • Testing Atlas’ inbuilt GPS accuracy on an oval near our workshop

5th Mar 2026

  • First time using a companion PC connected to Atlas for running the ROS network in our workshop. This allowed us to send commands to the flight controller using pymavlink by remoting into the companion PC

13th Mar 2026

  • Installation of a custom simulation PC in our workshop for running gazebo simulations of our platforms

18th Mar 2026

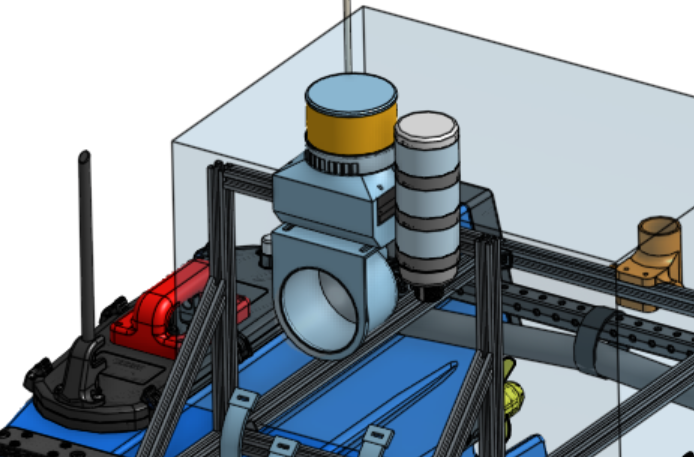

  • Installation of the first iteration of Atlas’ smart box which houses all of the computers responsible for autonomous capabilities

26th Mar 2026

  • Mounted LIDAR to Atlas

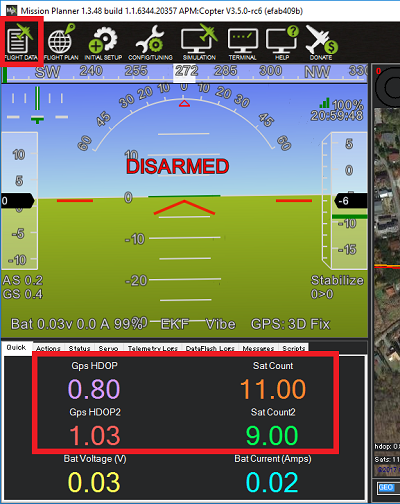

  • Testing our spatial dual GPS

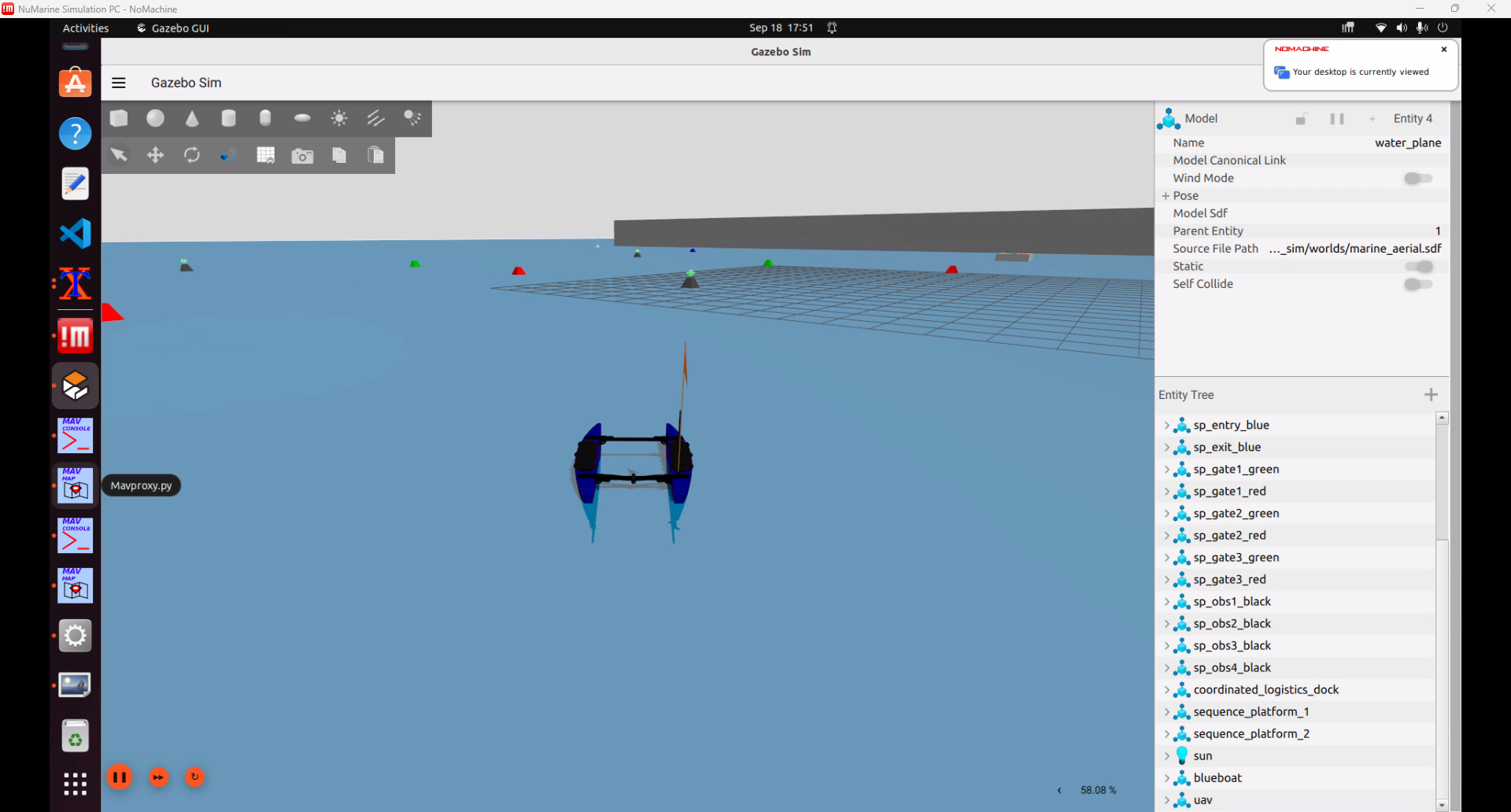

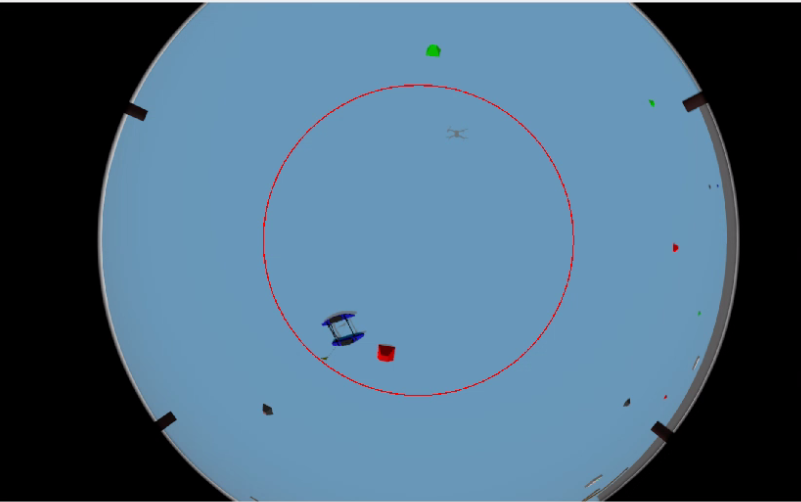

  • First multi-vehicle simulation run in gazebo on our simulation PC

27th Mar 2026

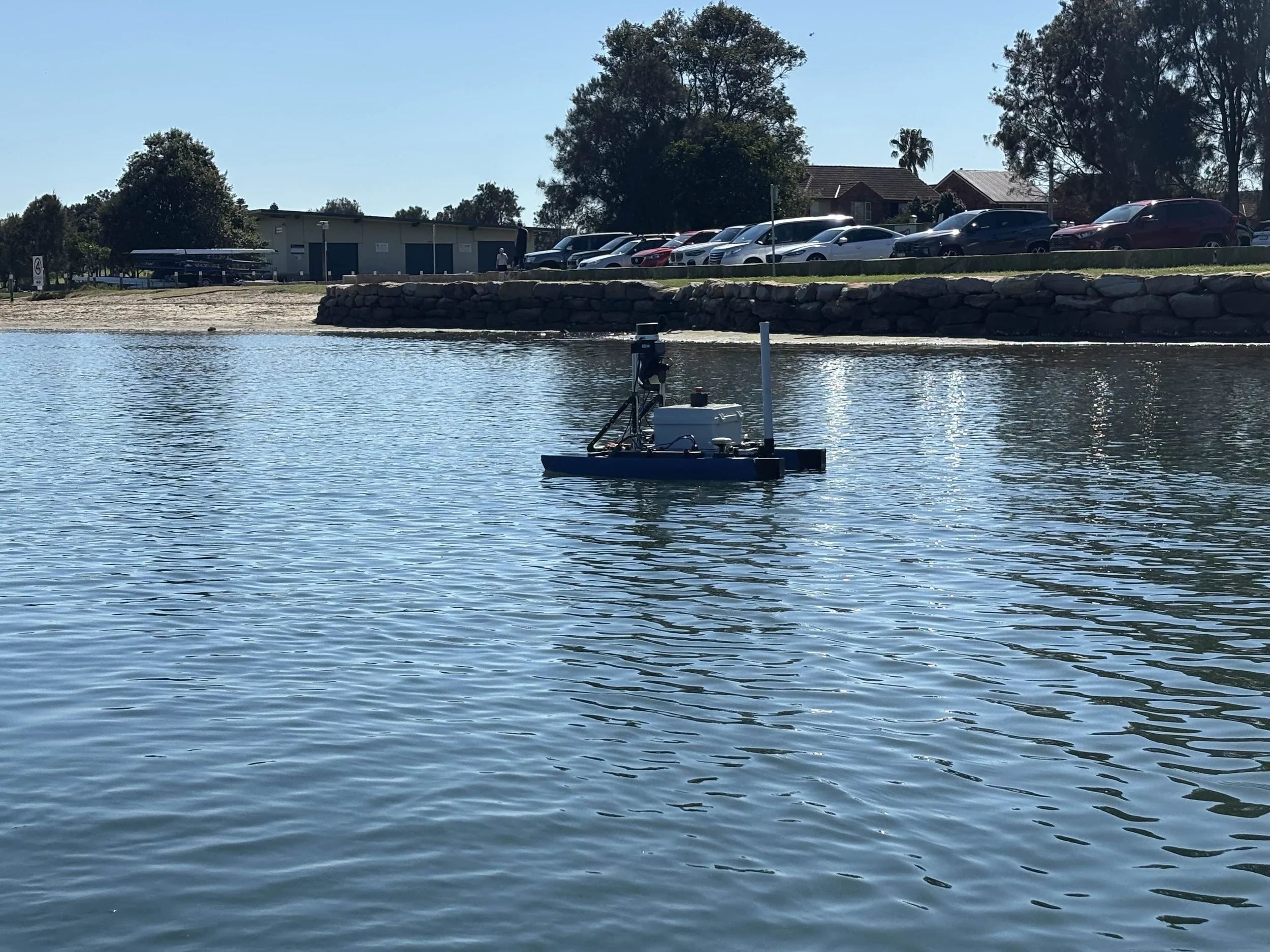

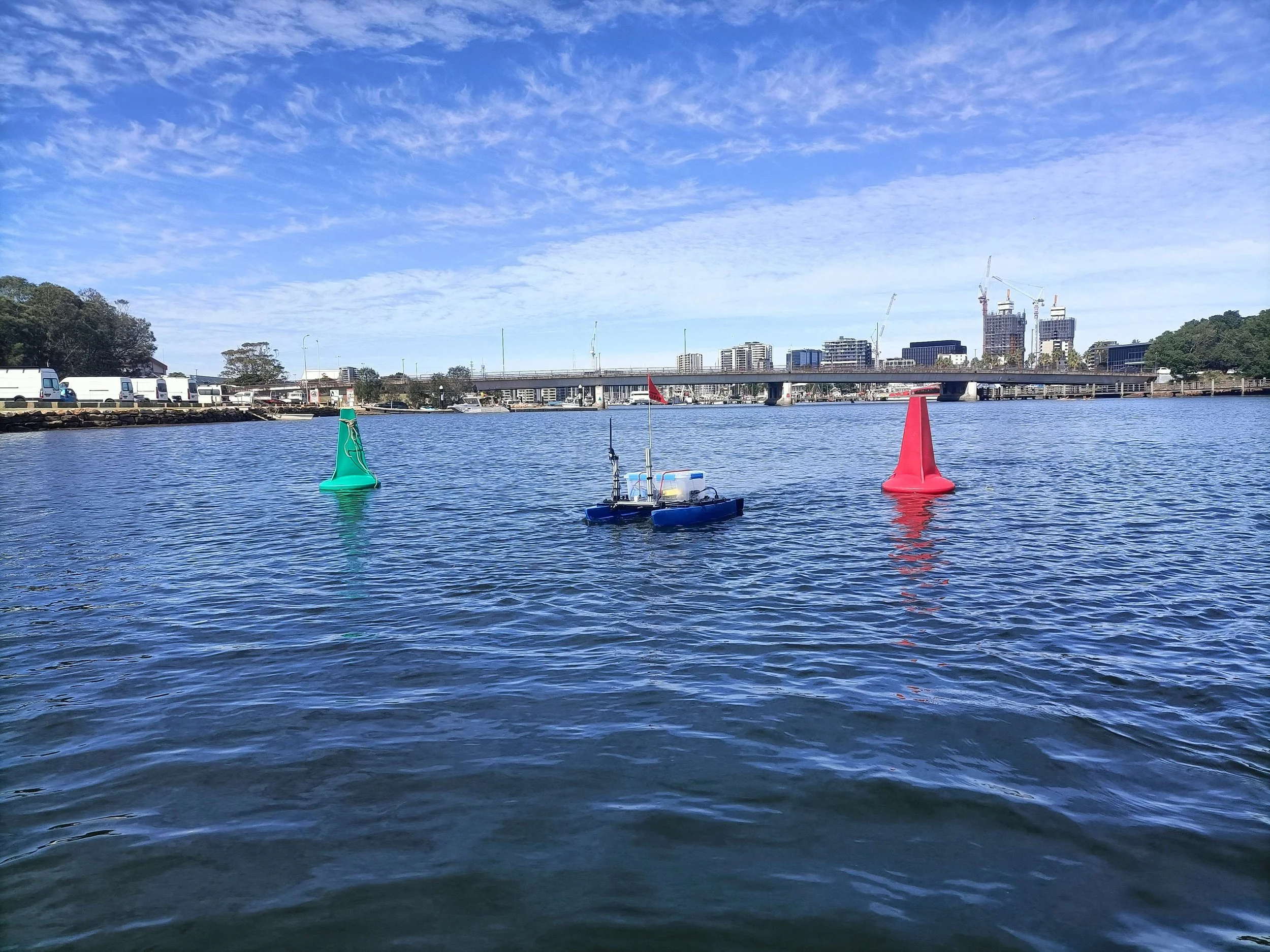

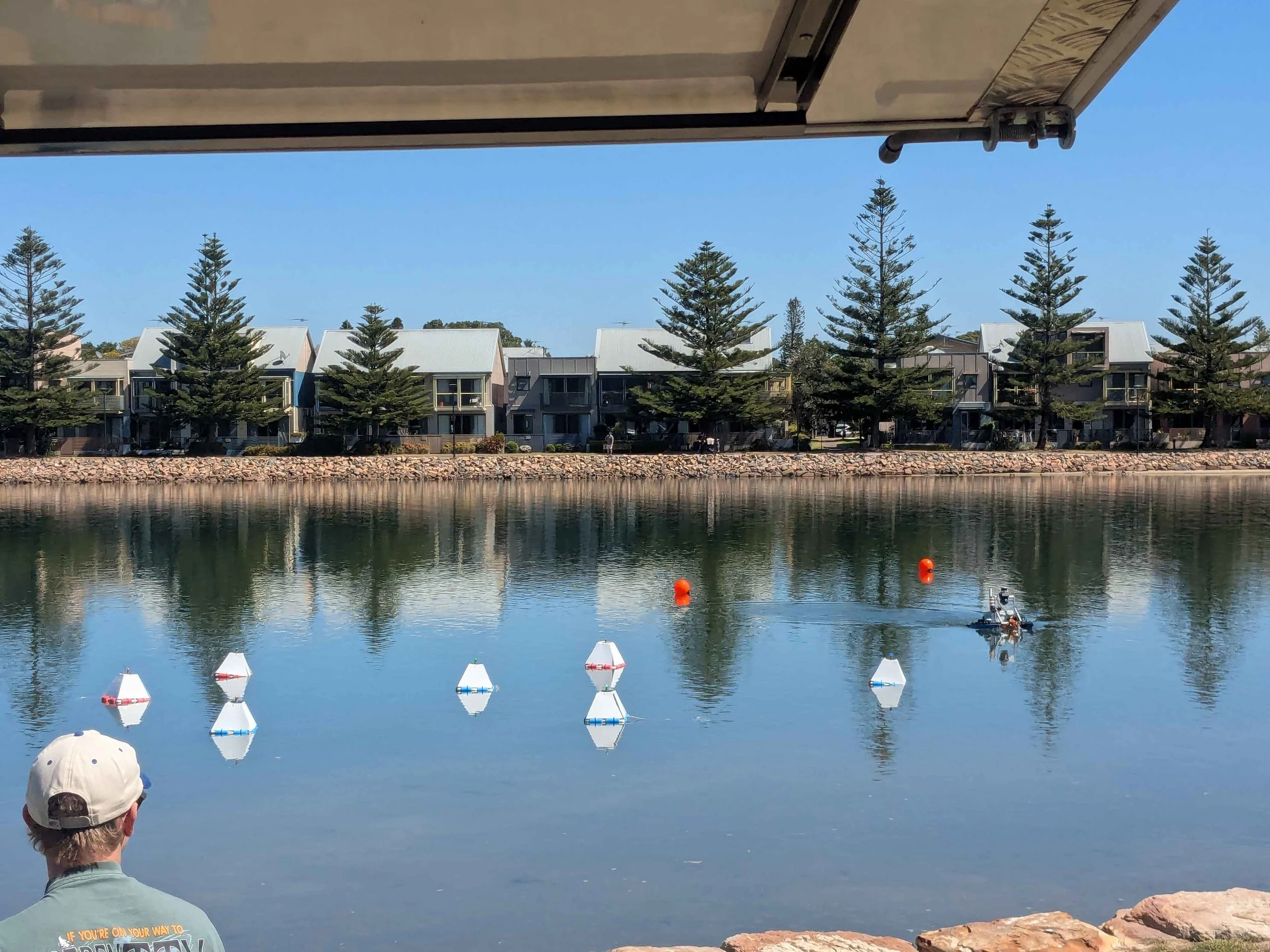

  • On the water test day where we deployed a GUI for use by our on-shore command centre to lace waypoints and monitor Atlas’ position/path

17th Apr 2026

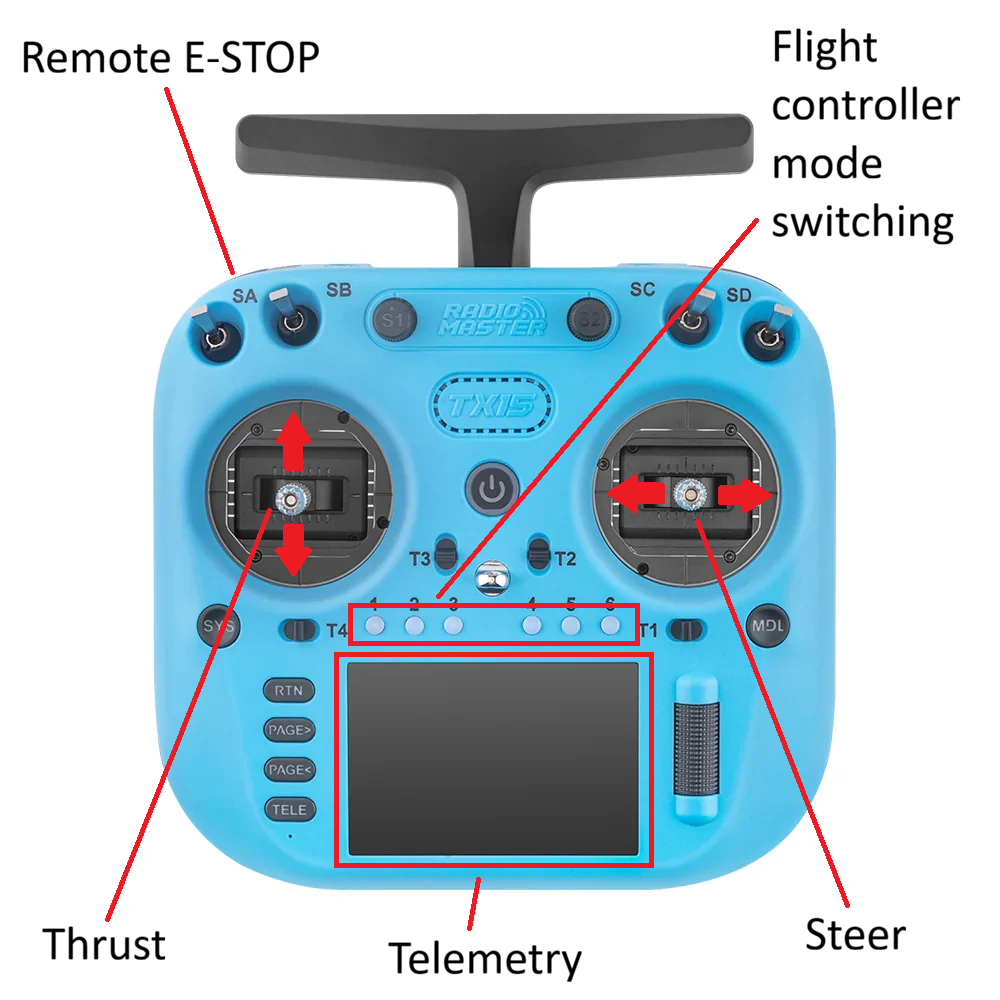

  • On the water testing of failure states and mode switching using ELRS remote

  • First test runs of basic waypoint and obstacle avoidance scripts

22nd May 2026

  • Testing of Ubiquiti WIFI antennas on the water

29th May 2026

  • Testing communications between our UAV, Artemis, and Atlas’ companion PC using Ubiquiti WIFI antennas

3rd Jun 2026

  • First iteration of robo-command node reads telemetry data from Atlas during on the water testing

  • Tested the weight capacity of the boat with its current hulls

15th Jun 2026

  • Initial testing of hydrophone array mounted to Atlas in order to localise an acoustic pinger

19th Jun 2026

  • Testing failure states of Atlas and the remote E-STOP

3rd Jul 2026

  • Initial test of our guidance algorithm on Atlas

  • Part of POR video recorded

21st Aug 2026

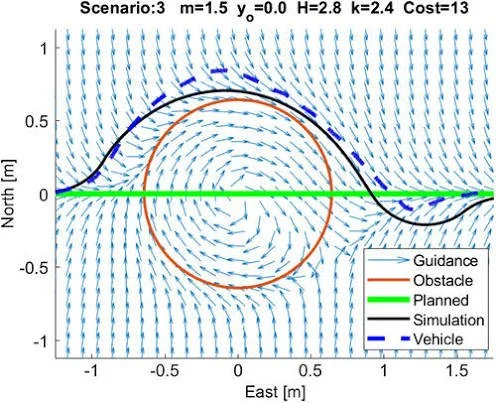

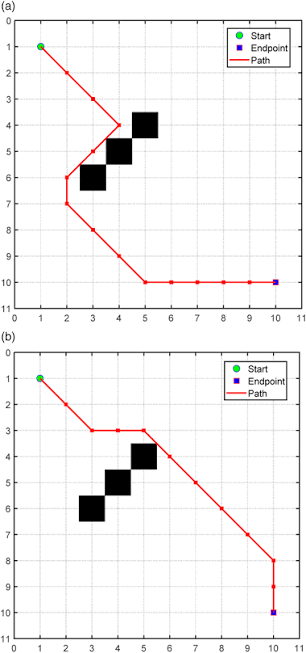

  • Testing of Voronoi corridor guidance solution on the water

24th Jul 2026

  • Tested mission planning architechture

11th Sep 2026

  • Live obstacle avoidance running using guidance and perception solutions working together

UAV - Artemis

4th - 11th Feb 2026

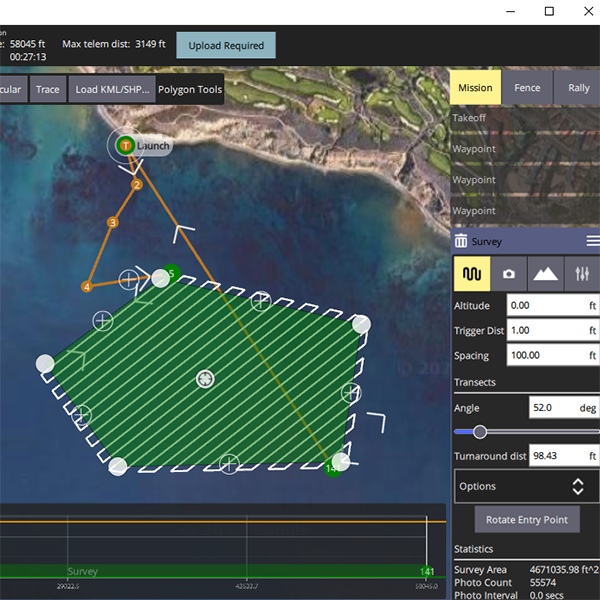

  • Set up mission planner, ardupilot, mavROS and SITL simulation for our UAV, Artemis

12th Mar 2026

  • Established control of simulated UAV using ardupilot and gazebo. Virtual flight controller was run as a SITL in conjunction with gazebo physics engine

25th - 31st Mar 2026

  • Set up ELRS remote control including telemetry of battery data and flight mode

8th Apr 2026

  • Ran a manual waypoint mission with our simulated UAV in gazebo (SITL)

20th Apr 2026

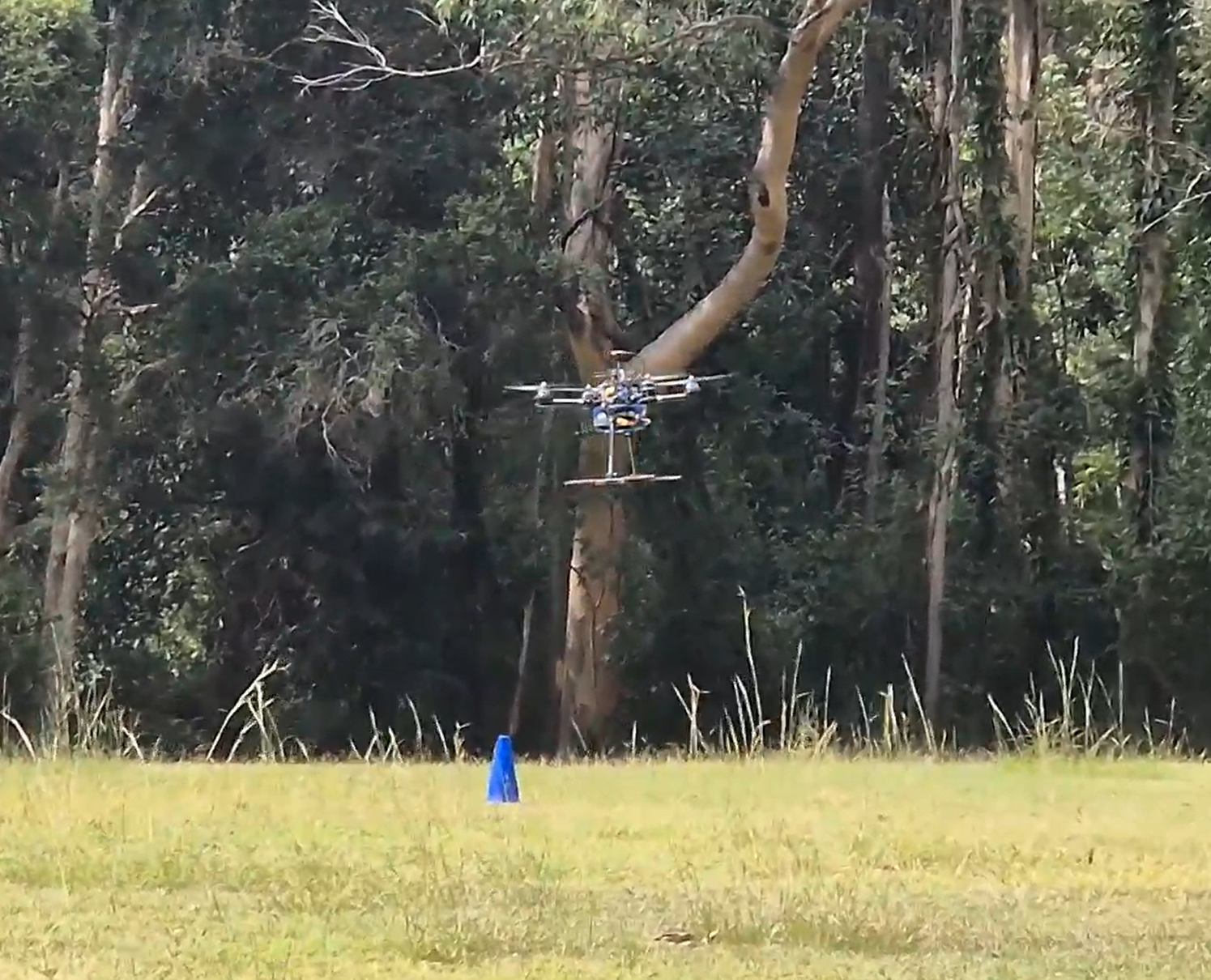

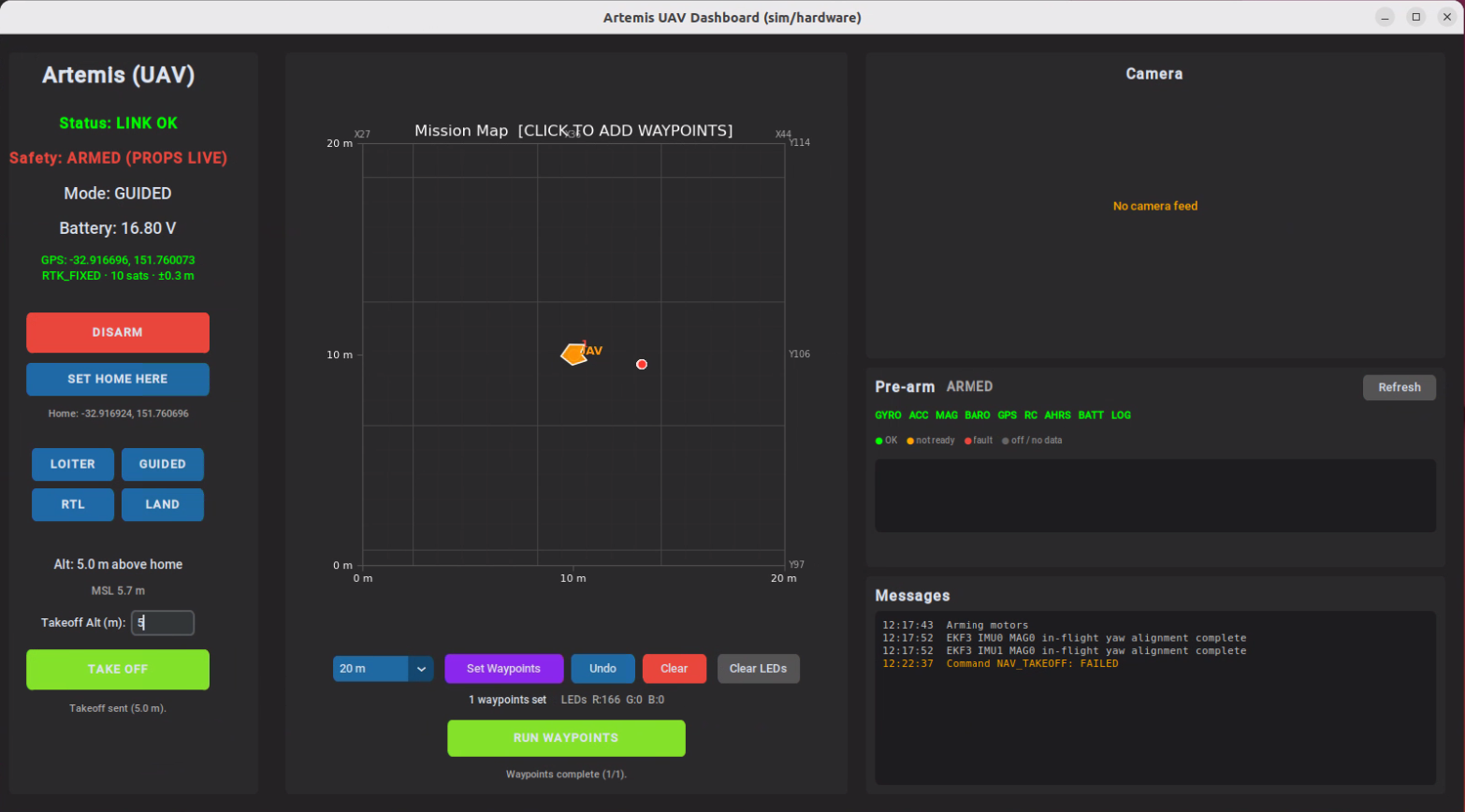

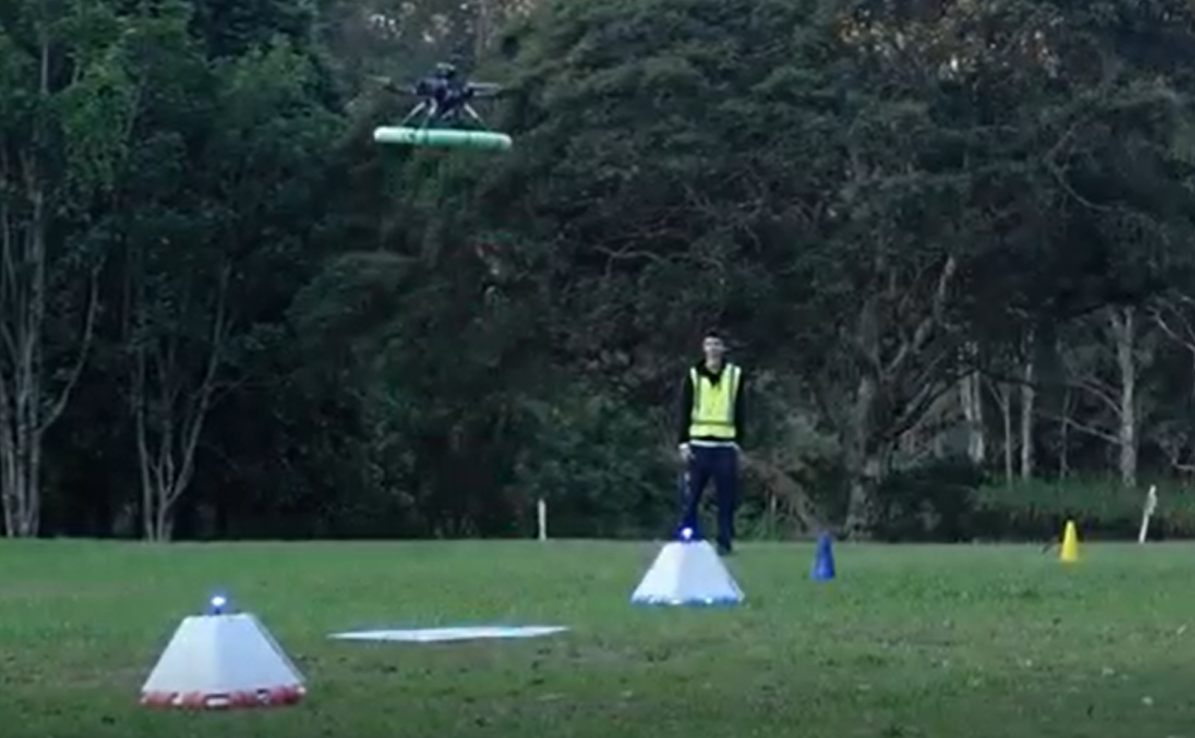

  • First UAV flight! (take off and land)

29th Apr 2026

  • UAV flight (calibrated accelerometer, validated RC inputs)

20th May 2026

  • UAV flight (premature use of auto-tune caused propeller failure)

27th May - 10th Jun 2026

  • Re-calibrate Flight Controller using manual tuning while grounded (non-flying calibrations)

19th Jun 2026

  • UAV flight. Hover test flight, collecting baseline flight data

8th - 22nd Jul 2026

  • Mechanical overhaul of the UAV including:

    • Redesign of landing gear

    • Fabrication of stronger chassis parts

    • Mounting designed for WIFI antenna

  • Selected new ESCs for reading motor RPM data

  • Configured ubiquiti bullet WIFI antenna

23rd Jul 2026

  • New, bi-directional ESCs configured (firmware flashed flashed and tuned)

24th Jul 2026

  • Updated pixhawk firmware on flight controller and configured bidirectional DSHOT on ESCs to be used for filtering out noise and improving flight performance

14th - 15th Aug 2026

  • PID tuning of each axis

18th - 22nd Aug 2026

  • Created POR videos and documents

17th Aug 2026

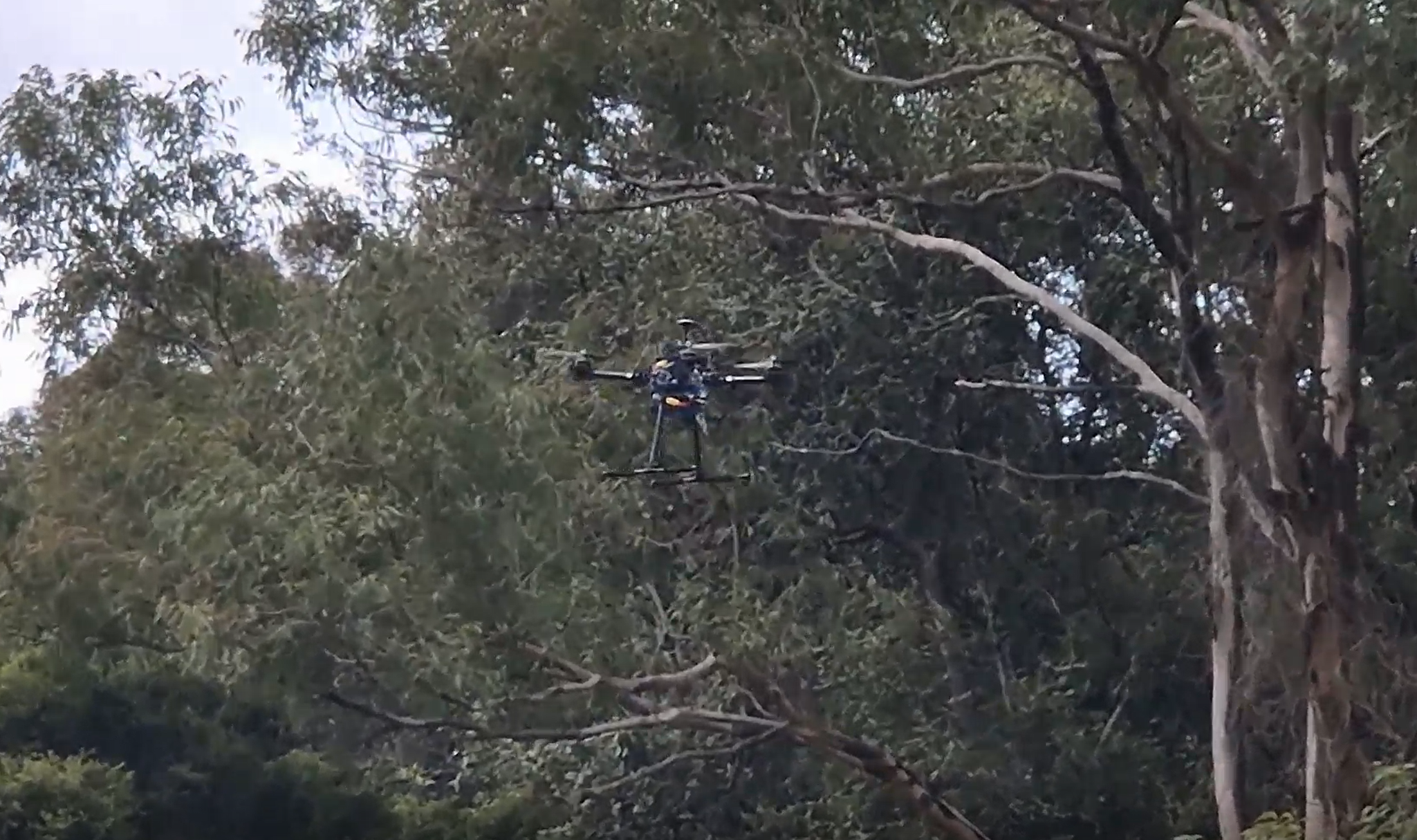

  • NU Marine’s first fully autonomous flight!

UUV - Bastet

26th Jan 2026

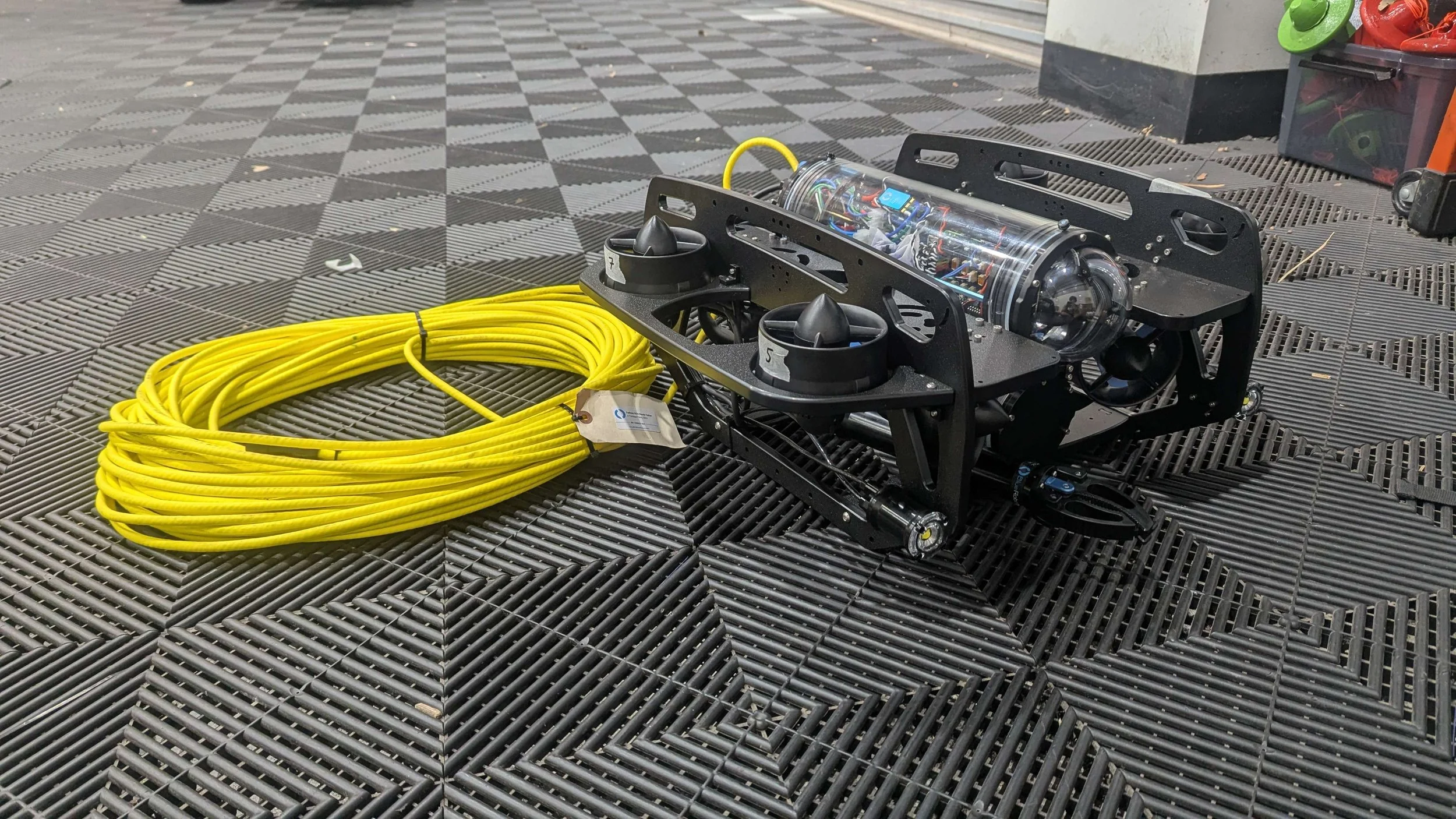

  • Assembly of our BlueROV2 UUV, Bastet

28th Jan 2026

  • Bench testing of Bastet (powered by power supply) and remote control configuration

13th Feb 2026

  • First SUB test day

    • System checks

    • Motor calibration

    • Emergency protocols validated

    • Practice tethered remote control operation

    • First buoyancy checks

17th Feb 2026

  • Blue Robotics SONAR mounted and connected in workshop

20th Feb 2026

  • SUB test day

    • Controller tuning

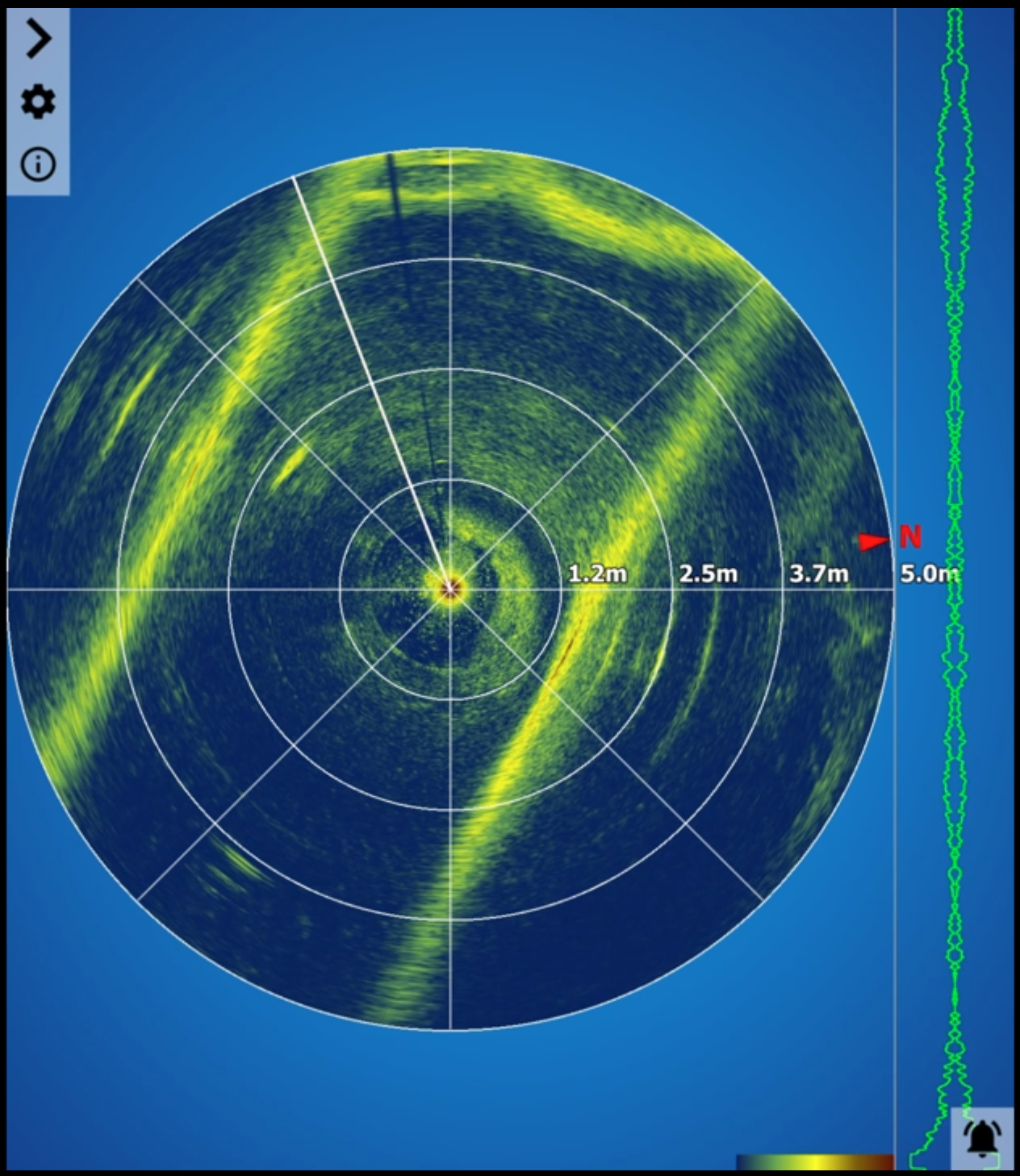

    • Tested SONAR using Ping Viewer

    • Validate that ROS can run python scripts/nodes to actuate motors

23rd Feb - 6th Mar 2026

  • Training camera vision model and research depth hold

10th Mar 2026

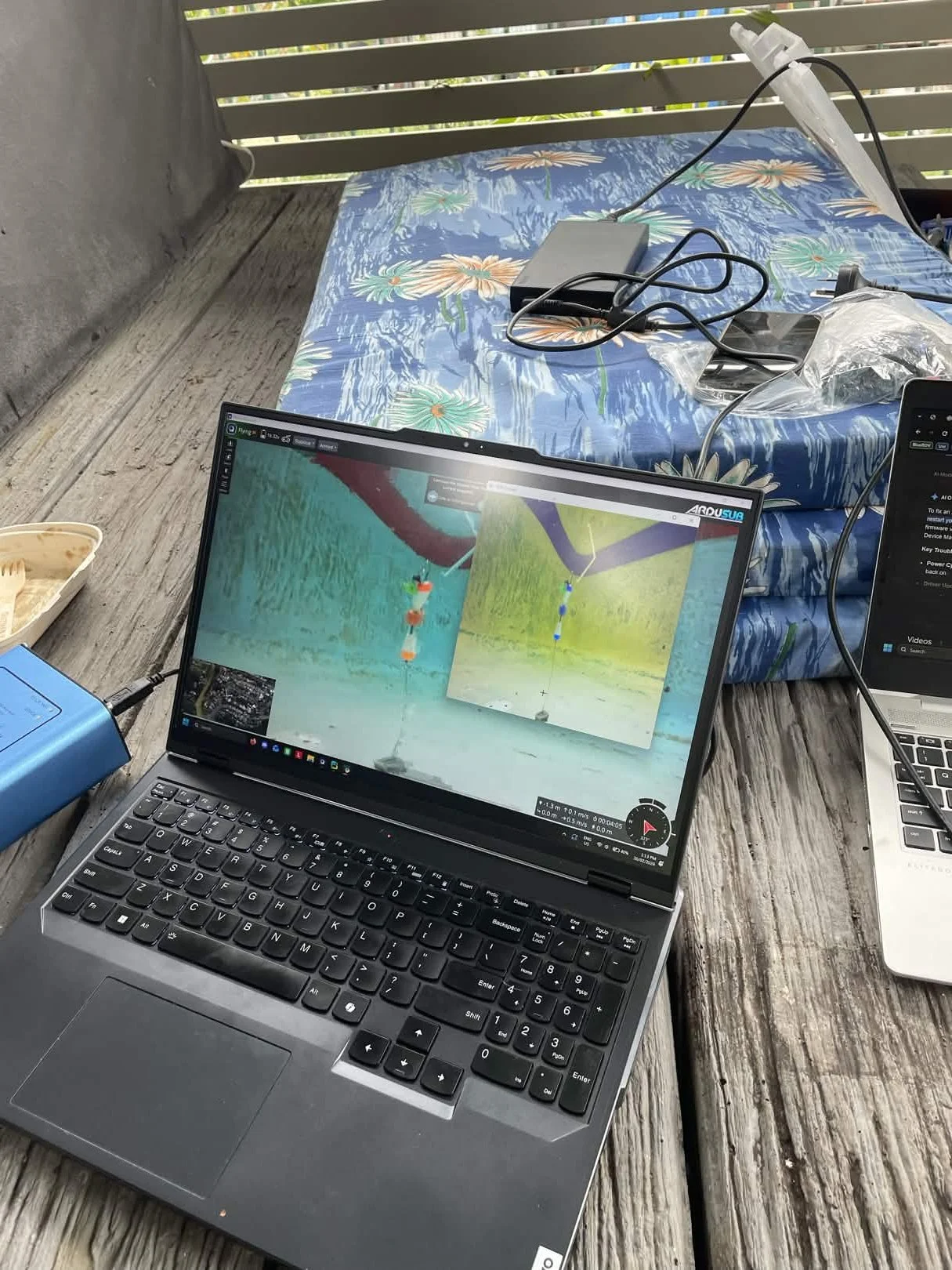

  • SUB test day

    • Tune depth hold

    • Collect SONAR data of pipe in water

    • Training of camera vision model

2nd Apr 2026

  • Research ability for BlueROV2 to hold a specified attitude

15th Apr 2026

  • SUB test day

    • Testing whether SONAR can detect pipe while not level (UUV is level when pitch = 0)

    • Velocity control of SUB motors using ROS node

    • Validated that SUB can detect and attempt to hold a specified attitude (however, position hold required additional sensors)

2nd Jul 2026

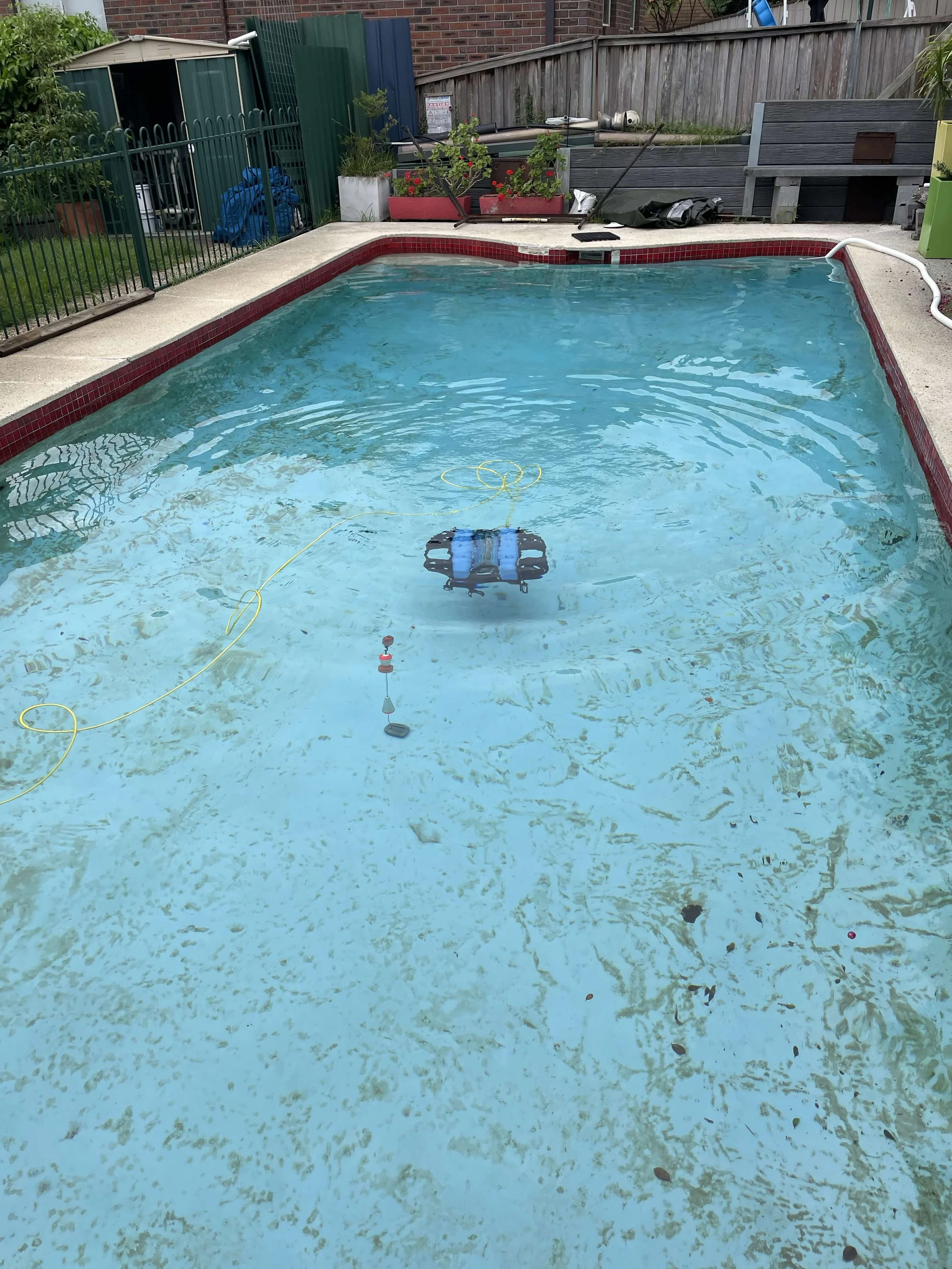

  • Mounted and tested Doppler Velocity Logger in our workshop

8th Jul 2026

  • SUB test day

    • Doppler Velocity Logger displays relative position and velocity

    • Flight controller enters auto mode and attempts to follow waypoints
